Will Grantham Ever Get Its Bypass? Brunel And Thatcher Would Have Wept
Anyone interested in an allegory of Britain’s relentless slide into inertia and a shadow of its former self need look no further than the trials and tribulations affecting the desperately needed bypass for the East Midlands town of Grantham, famously the birthplace and childhood home of Baroness Thatcher, and a vital transport crossroads hub in the heart of the country.
The works have been under construction for years, with part of the project being completed a staggering decade ago. They involve the east-west A52 being diverted to cross the East Coast mainline and the A1 to pass south of Grantham.
According to New Civil Engineer, in a piece from last autumn:
The opening of the Grantham Southern Relief Road (GSRR) in Lincolnshire has been pushed to late 2027 at the earliest as issues relating to installation of a new bridge on the project are dragging on.
Lincolnshire County Council’s GSRR is a new 3.5 km road between the A52 and the A1 being intended to reduce congestion and provide growth opportunities. It is being delivered in three phases, with the first two having been completed in 2016 and 2022 respectively. The third phase, designed by WSP and being delivered by Galliford Try, was expected to complete this year but has hit a significant issue with a new bridge that will cross the East Coast Main Line and the River Witham.

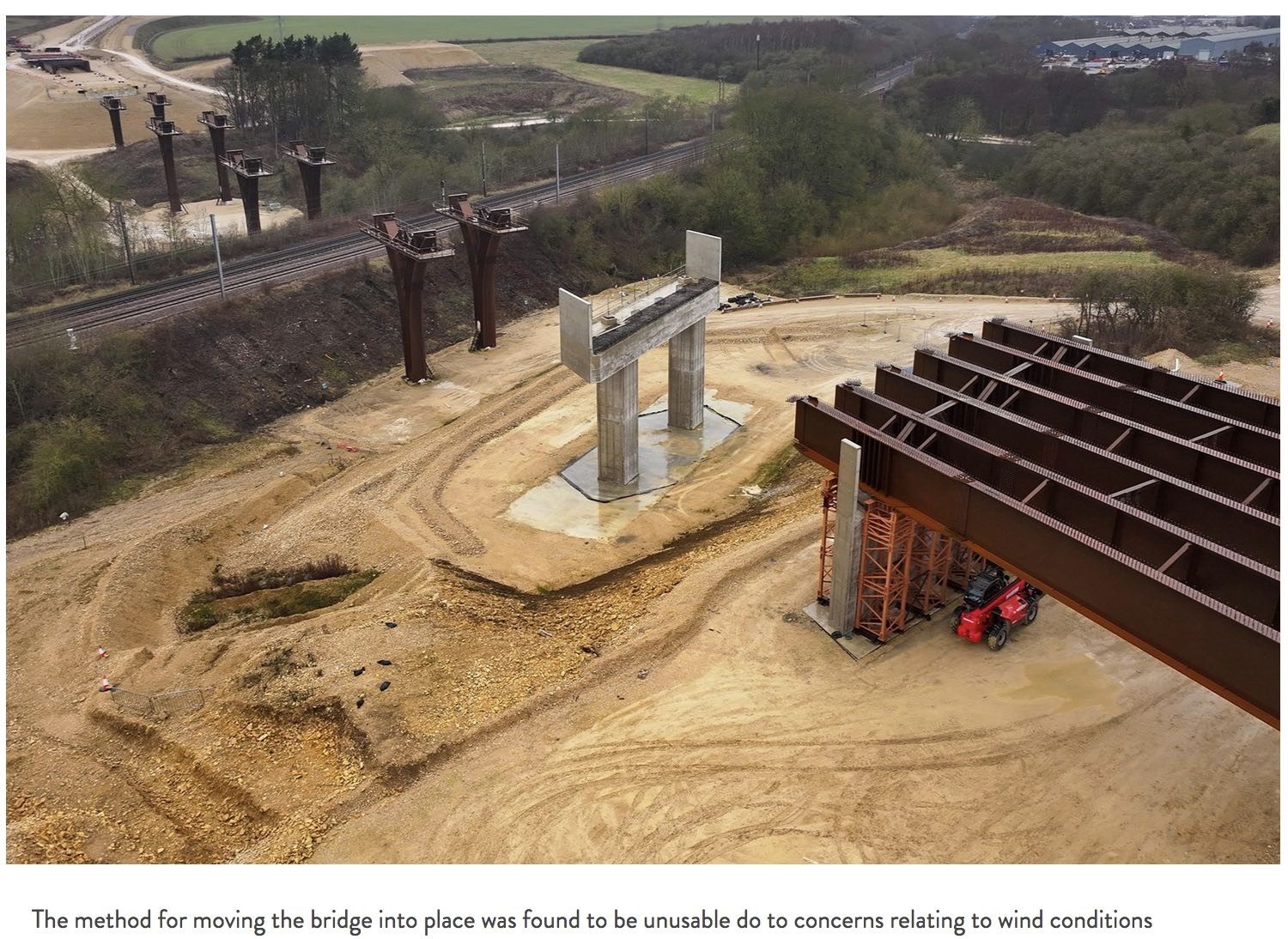

In February [2025], the council revealed that the project had encountered issues relating to the installation of the 293m long, 2,500t span. The devised method for pushing it into place over the railway and river was found to be unusable due to “concerns relating to specific wind conditions”, according to then Lincolnshire County Council executive member for highways Richard Davies. This was expected to delay the road opening into 2026 and push the cost of the project up by £10-20 million.
In an update from the middle of August, new Lincolnshire County Council executive member for highways Michael Cheyne said that a new temporary guiding structure for the bridge was set to arrive imminently and would be attached to the front of the bridge “over the coming months”.
However, a council spokesperson has now confirmed to NCE that the guiding structure has not yet arrived and is instead expected in October. Additionally, its cost is “not yet agreed”, according to the council spokesperson.
According to Cheyne in August 2025, “I can say with confidence that, once the bridge push does start, it will be approximately two years until the road can open. Please rest assured that I’ll be doing everything in my power to ensure this project doesn’t slip any further.”
However, by February 2026 little has happened since, according to a Lincolnshire County Council update, such as “West side of site – install temporary works to Pier 3 / maintenance for working platform at Pier 2 and 3.” Which doesn’t exactly sound like progress.
Meanwhile, in the United States the 1.6-mile-long Francis Key Bridge, which was badly damaged when a ship collided with it in March 2024, is projected to have been rebuilt to a completely different design by late 2030. The works have included demolishing and removing the old bridge, as well as planning the new one, both having been wholly unexpected. The new bridge will be almost nine times as long as Grantham’s vastly less complex new bridge.

The Chinese managed to build the Huajiang Grand Canyon Bridge in three years, completing it last year. It’s suspended 2,050 feet (625 metres) above the river below.

Famously, Isambard Kingdom Brunel’s design for the 1,352 feet long (412 metres) Clifton Suspension Bridge in Bristol, which used existing towers and included significant modifications to Brunel’s, was constructed between 1862 and 1865 (Brunel had died in 1859). His Royal Albert Bridge over the Tamar between Plymouth and Saltash was built between 1854 and 1859 and is over twice the length of the projected Grantham bypass bridge.
Meanwhile, the best that the leader of Lincolnshire County Council, Reform’s Sean Matthews, could come up with last week was “the council still needs to deal with delays to the Grantham bypass due to a design error, and the Spalding ‘Road to Nowhere’ which remains unfinished”.
Reform of course only took control of Lincolnshire in the elections of May 2025.
However, for now the bypass opening looks dangerously like dragging on into 2028. Recent drone footage shows the works in progress, if you can call it that. One wonders what Brunel, whose first name Isambard means ‘Man of Iron’, and our own celebrated late Iron Lady would have made of Grantham’s bypass woes.
